Initial data entry after deployment
Rediflow: Project flow. Portfolio flow. One flow.
Feed the system with initial data after deployment. You don't need to do everything at once — start small, add more when you need it. Each step covers: What to do, Why it matters, How to do it, and How to verify it worked.
After entering data, use Data quality monitoring (Project → Settings → Data quality check, or Settings → Data quality monitoring) to verify and resolve issues. See Fix data quality errors.
Screenshots are auto-generated; your UI may vary slightly.
Phase 1: First-time user (minimum to get going)
Step 1: Prerequisites
What: Ensure migrations have run and the app is started.
Why: The database must have the schema and project lifecycle states before you add data.
How:
- Start PostgreSQL (e.g.
podman compose up -d). - Set
DATABASE_URLin your environment (e.g..env.dev). - Run
uv run python main.py migrate. - Optionally run
uv run rediflow seed-calendarsfor country holidays (FI, SE). - Start the app:
uv run python main.py run. - Open http://127.0.0.1:5000 in your browser.
When using container deployment (QA or production): The app and database start with the stack. Run migrations and seed-calendars inside the container. See Deploy QA and production and Seed projects and calendars for the full workflow.
Verify: The home page loads. If setup info is shown, you're ready to add data.

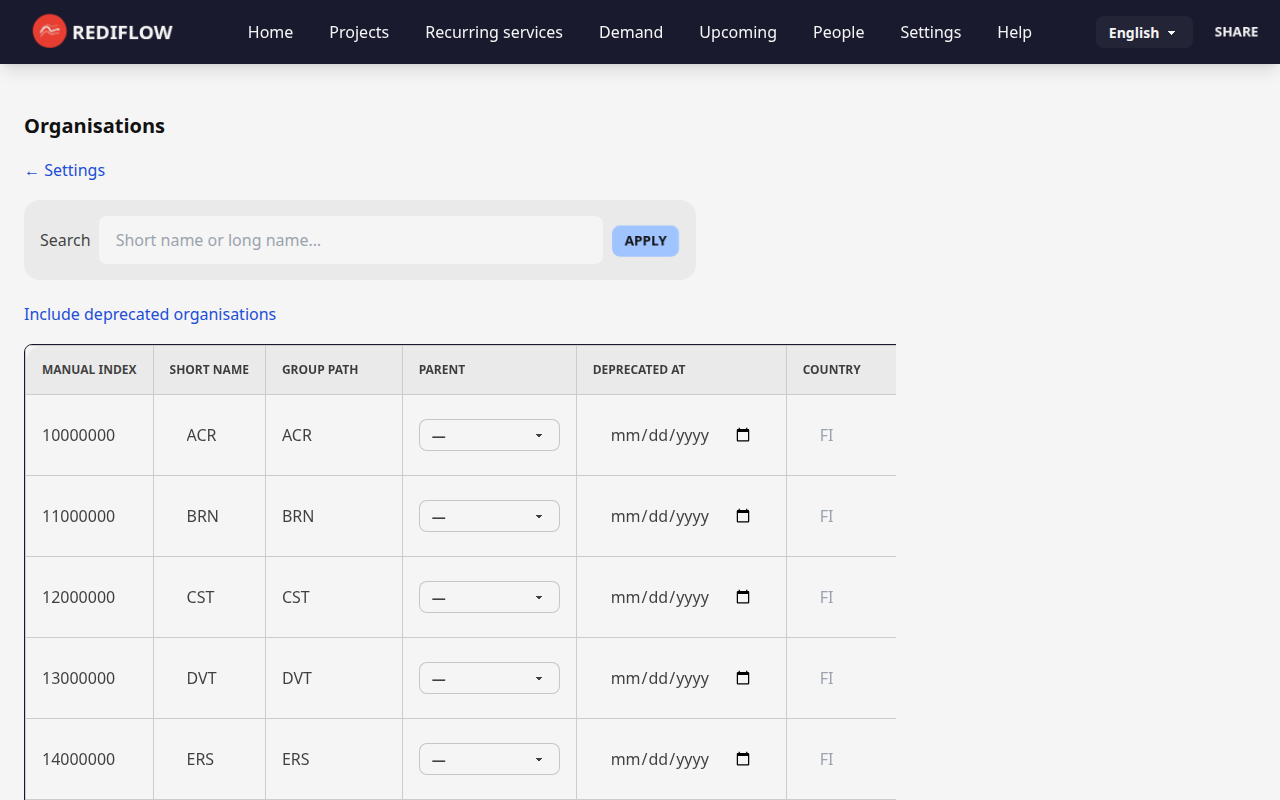

Step 2: One organisation
What: Add at least one organisation (we use Example_com in this guide).
Why: Without an organisation, you cannot set a Project Owner Organisation (POO) when creating a project. The POO identifies who owns each project.
How:
- Go to Settings (top navigation).
- Click ORGS.
- In the last row of the table, enter Example_com in the Short name column.
- Click Save.

Verify: You see Example_com in the ORGS list. You can also create an organisation on-the-fly when creating your first project (type a short name in "Or new org").

Step 3: Role type group and role type
What: Add one role type group and one role type (e.g. "Default" and "PM").
Why: Role types power the "Home organisation role" on tasks and milestones. Without them, those dropdowns stay empty.
How:
- Go to Settings → Role type groups.
- In the new row, enter Default as the group name. Click Save.
- Click Edit role types.
- In the new row, select the Default group, enter code PM and label Project Manager. Click Save.

Verify: You see the Default group and the PM role type. You can add more later.
Step 3a: Home organisation role group and home organisation roles
What: Add one home organisation role group and at least one home organisation role (e.g. "Default" and "Lead").
Why: The "Home organisation role" column on tasks, milestones, and deliverables needs these. Without a group and roles linked to it, that dropdown stays empty. Projects select a home organisation role group in settings; only roles from that group appear in the dropdown.
How:
- Go to Settings → Home organisation role groups.
- In the new row, enter Default as the group name. Click Save.
- Click Edit home organisation roles.
- In the new row, select the Default group, enter code Lead and label Lead. Click Save.
- Add more roles as needed (e.g. Ben, n/a).
Verify: You see the Default group and at least one home organisation role. When creating a project, set Home organisation role group in Project → Settings → Project schemes so the Home organisation role column shows these roles.

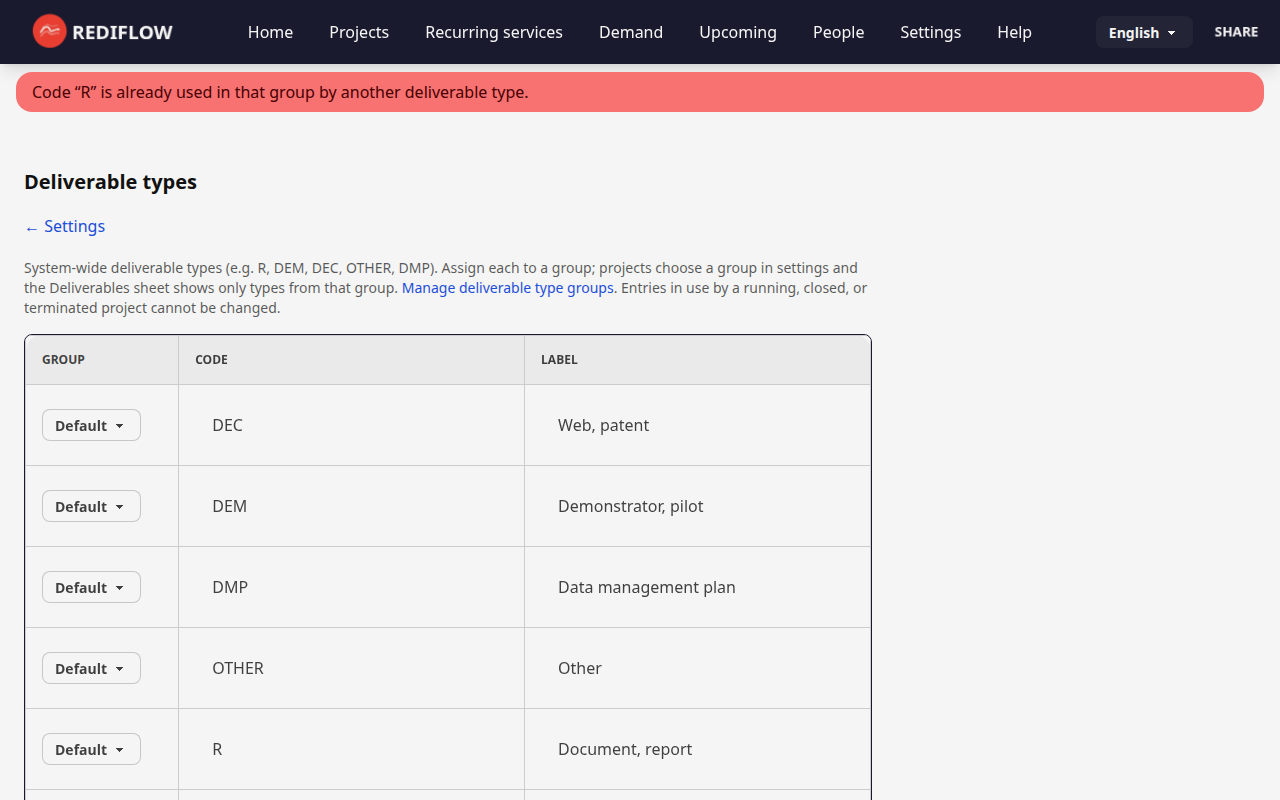

Step 4: Deliverable type group and deliverable type
What: Add one deliverable type group and one deliverable type (e.g. "Default" and "R" for Report).
Why: Required for the Deliverables sheet. Projects can later restrict to a specific group in their scheme.
How:
- Go to Settings → Deliverable type groups.
- Add group Default. Click Save.
- Click Edit deliverable types.
- Add type R with label Report in the Default group. Click Save.

Verify: You see the Default group and the R type.

Step 5: Dissemination level group and dissemination level
What: Add one dissemination level group and one level (e.g. "Default" and "PU" for Public).
Why: Required for the Deliverables sheet (dissemination column). Same idea as deliverable types.
How:
- Go to Settings → Dissemination level groups.
- Add group Default. Click Save.
- Click Edit dissemination levels.
- Add level PU with label Public in the Default group. Click Save.

Verify: You see the Default group and the PU level.
Step 6: Create first project
What: Create your first project with name, duration, dates, and Project Owner Organisation (POO).
Why: Projects are the core unit. You need at least one to add work packages, tasks, milestones, and deliverables.
How:
- Go to Projects (top navigation).
- Click New project.

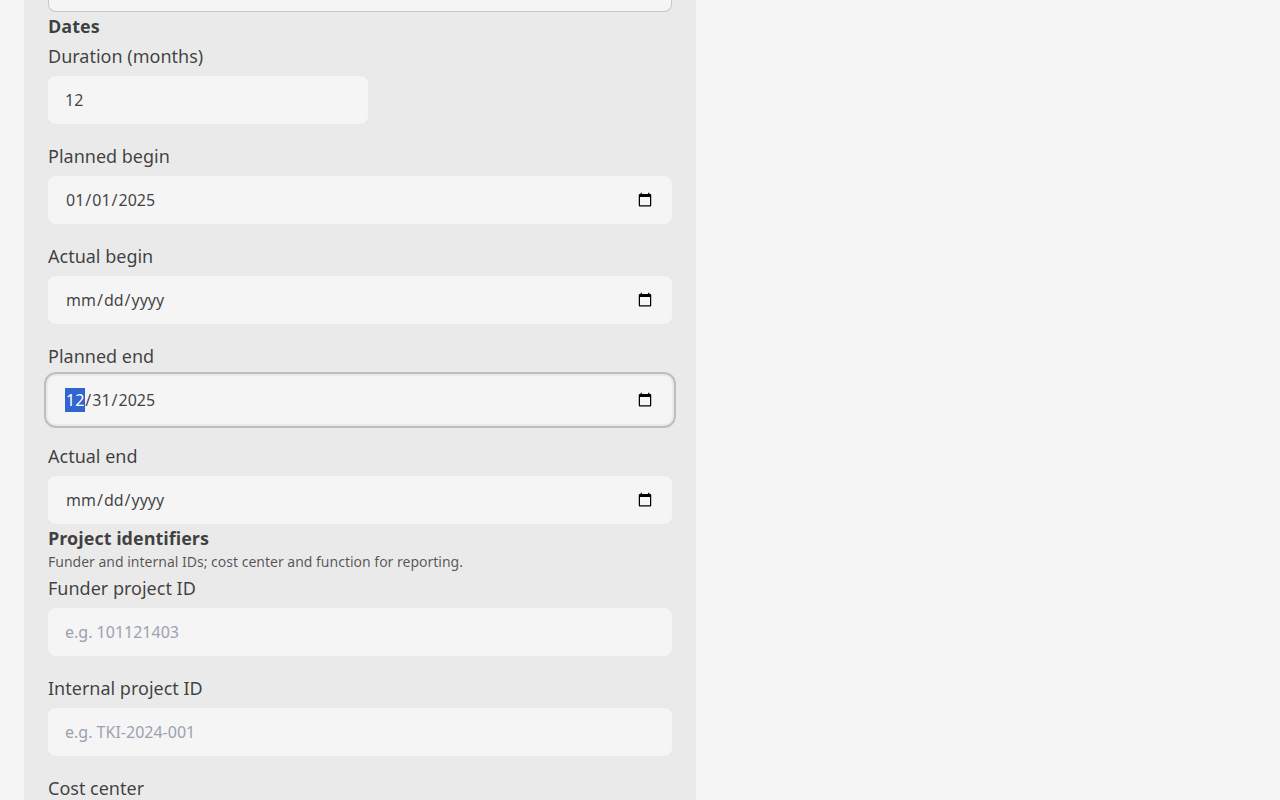

- Enter Name (e.g. "First project"), Duration (months) (e.g. 12), Planned begin and Planned end dates.
- Select Project Owner Organisation (POO) = Example_com (or type a new organisation name in "Or new organisation").
- Click Create project.
- Open the project → Settings → Project schemes. Set Home org role group = Default (and optionally Role type group, Deliverable type group, etc.) so the Home org role column on tasks, milestones, and deliverables shows the roles you added.

Verify: The project opens and you see project settings. You can now add WPs, tasks, etc. when ready.
Phase 2: Add tasks and deliverables

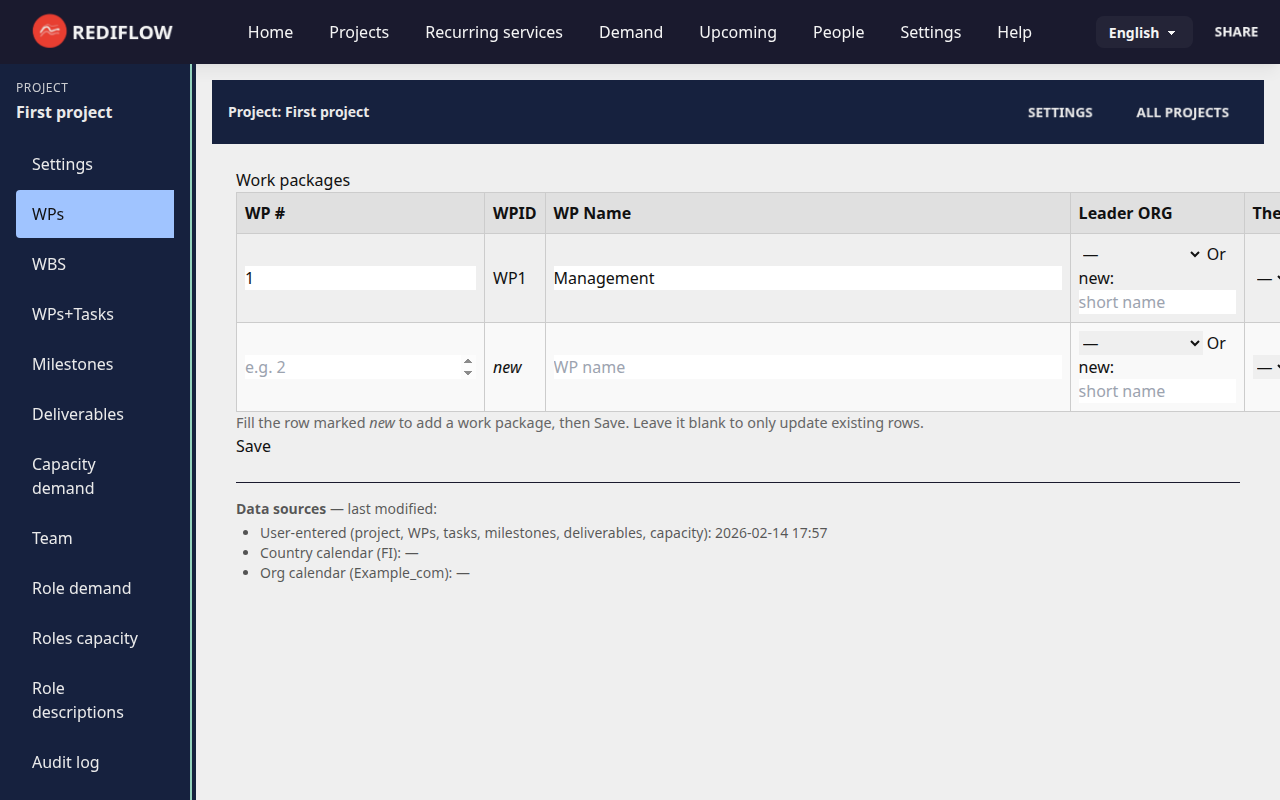

Step 7: One work package
What: Add one work package (WP) to your project.
Why: Tasks belong to a work package. You need at least one WP before adding tasks.
How:
- Open your project.
- Click WPs in the project sub-navigation.
- In the new row, enter 1 for WP # and Management (or any name) for WP Name.
- Click Save.

Verify: You see WP1 in the WPs sheet.

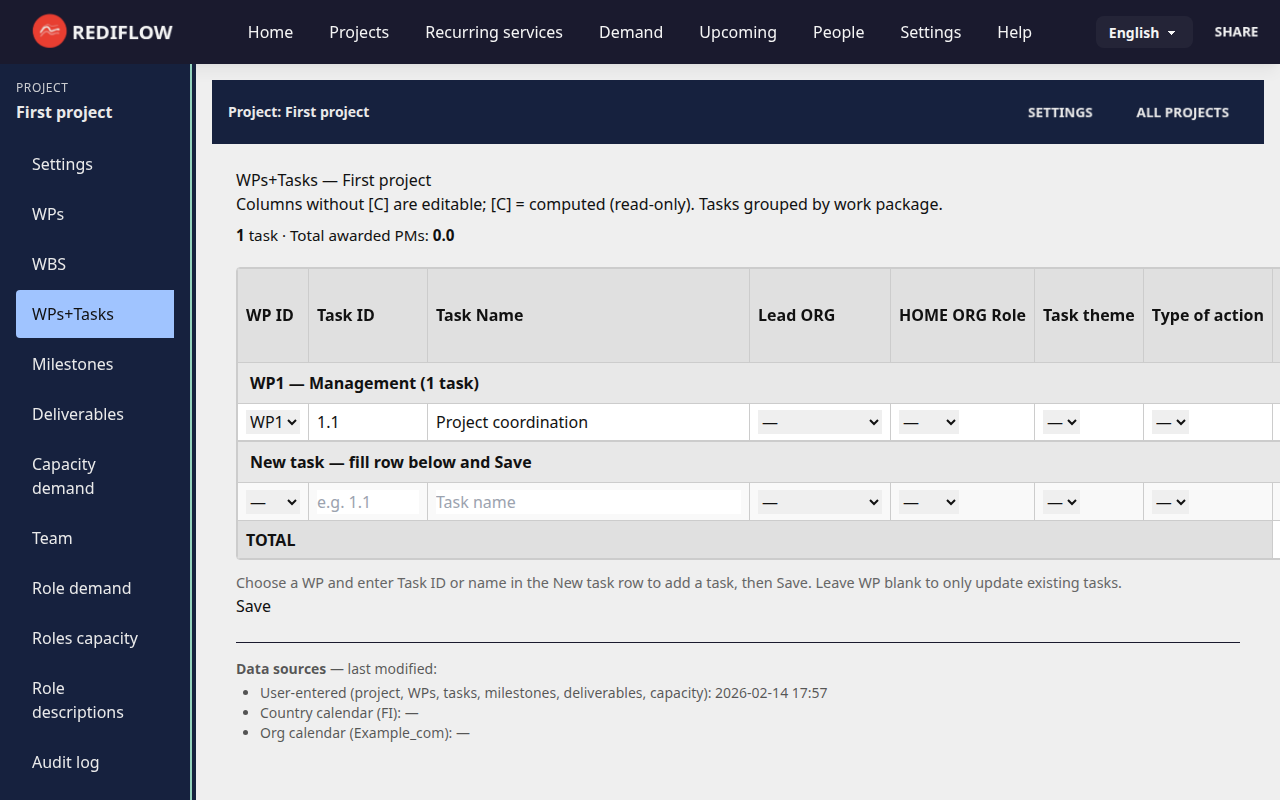

Step 8: One task
What: Add one task under the work package.
Why: Tasks are the unit of work. Adding one verifies the flow and lets you use capacity demand.
How:
- Click WPs+Tasks in the project sub-navigation.
- In the "New task" row, select WP1, enter task ID 1.1 and name Project coordination.
- Click Save.

Verify: You see the task under WP1. You can optionally add milestones and deliverables next.
Phase 3: Add more projects
Step 9: Second and third projects
What: Create two more projects (up to three total), all with POO = Example_com.
Why: A portfolio typically has multiple projects. Keeping them under one org first keeps setup simple.
How:
- Go to Projects → New project.
- Create Second project (duration, dates, POO = Example_com). Save.
- Create Third project (duration, dates, POO = Example_com). Save.

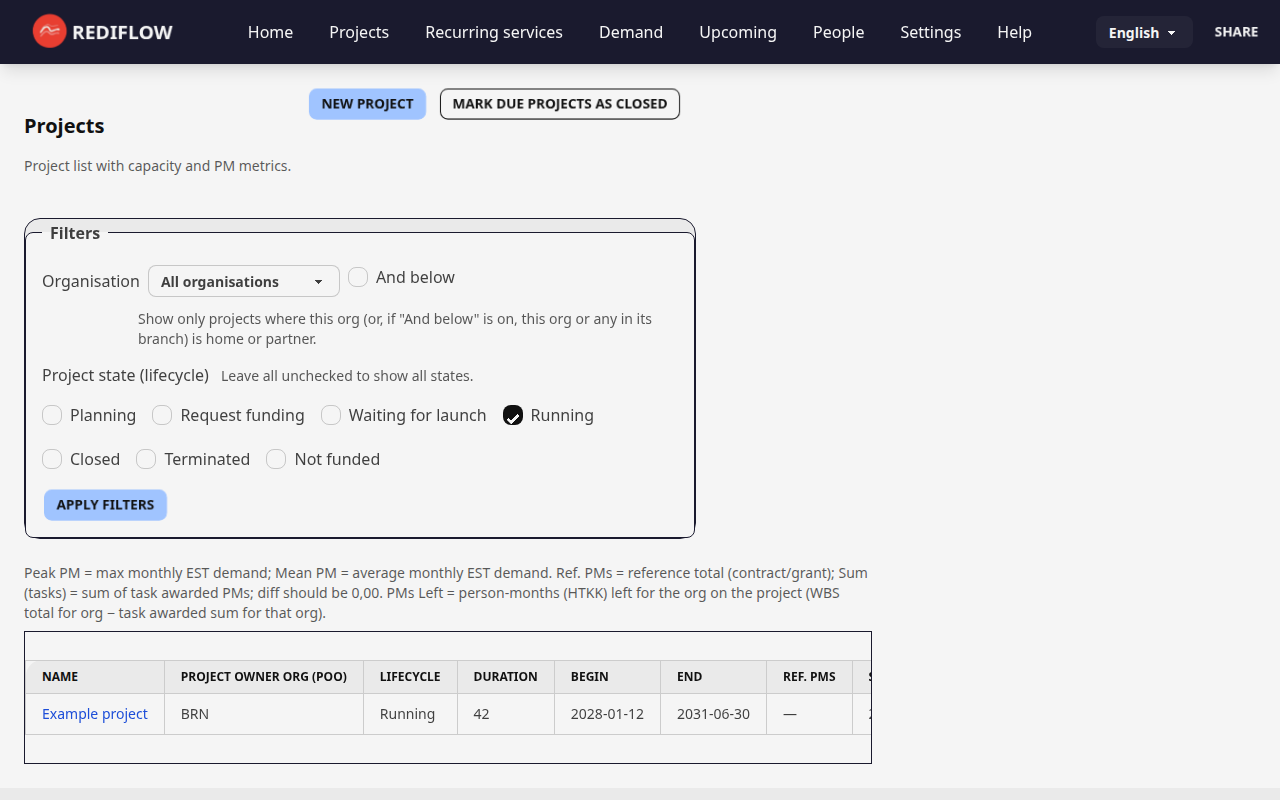

Verify: The projects list shows three projects; all owned by Example_com.
Phase 4: Full org structure
Step 10: Add org branches
What: Add BranchA and BranchB as children of Example_com.
Why: A hierarchy lets you organise projects by business unit. Child orgs inherit country code and non-working days from the parent.
How:
- Go to Settings → ORGS.
- In the new row, enter BranchA, set Parent = Example_com. Click Save.
- In the new row, enter BranchB, set Parent = Example_com. Click Save.

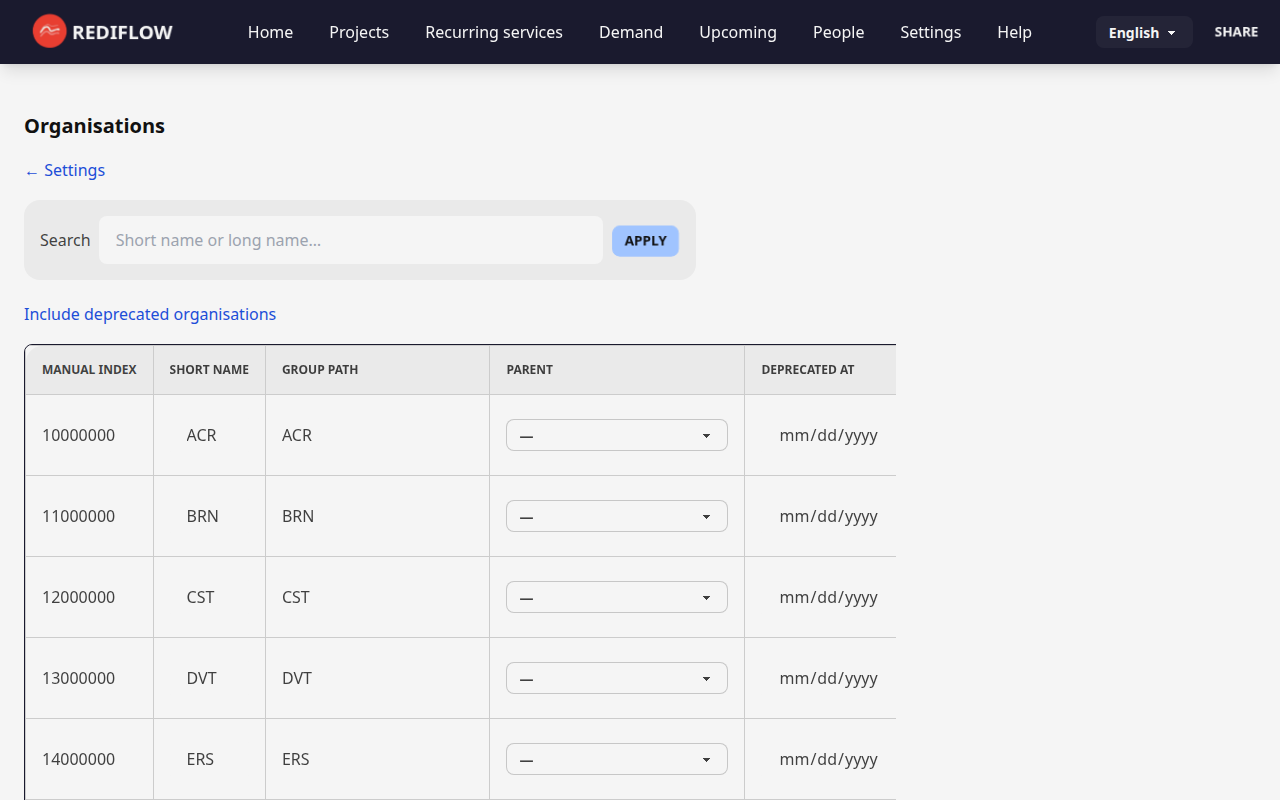

Verify: The ORGS list shows Example_com with BranchA and BranchB as children.
Phase 5: Projects across org branches

Step 11: Assign projects to branches
What: Change project 2's POO to BranchA and project 3's POO to BranchB.
Why: Distributes projects across the org structure. Demand and portfolio views can filter by org.
How:
- Open Second project → Settings.
- Change Project Owner Organisation (POO) to BranchA. Click Save.
- Open Third project → Settings.
- Change Project Owner Organisation (POO) to BranchB. Click Save.
- Go to Demand (or Graph → project view) to see projects by org.

Verify: Demand/portfolio views show projects distributed across org branches.
Checklist
Phase 1–2 (first-time user):
- [ ] Migrations + seed-calendars
- [ ] One org Example_com (or create on first project)
- [ ] One role type group + one role type
- [ ] One home org role group + one home org role (linked to that group)
- [ ] One deliverable type group + one deliverable type
- [ ] One dissemination level group + one dissemination level
- [ ] First project (name, duration, dates, POO = Example_com)
- [ ] (Optional) One WP, one task
- [ ] Verify: project opens, task visible
Phase 3 (more projects):
- [ ] Second project (POO = Example_com)
- [ ] Third project (POO = Example_com)
- [ ] Verify: three projects in list
Phase 4 (full org structure):
- [ ] Add BranchA, BranchB as children of Example_com
- [ ] Verify: org hierarchy visible
Phase 5 (projects across branches):
- [ ] Project 2 → POO = BranchA
- [ ] Project 3 → POO = BranchB
- [ ] Verify: Demand shows projects by org
Add when needed (Phase 6)
- WBS — Participant orgs and PMs per WP when you need capacity breakdown.
- WP themes, Task themes, Task type of action — For categorising work packages and tasks.
- Person capacity (if enabled) — Employee groups, allocation groups, people, team, role demand.
See also
- Overview — What Rediflow is and how to get started
- Clean database start — Reset or create a fresh database
- Import project from ODS — Import existing project data from a spreadsheet
